New Felbermayr company headquarters

Up-to-date information about the construction progress at a glance

After many long years of searching for the right location, the construction of the new Felbermayr headquarters started in September 2019. The outdoor facilities, the civil engineering works and the shell construction are being carried out internally by the Felbermayr Bau and the Transport- und Hebetechnik business units. 40,000 square metres of construction is being carried out on an area of 100,000 square metres. Around 700 employees will work in the new offices, workshops and halls. A childcare facility, fitness area and employee restaurant will be established in our own social building. All components are linked underground through the underground car park, which has space for 400 cars. Completion is planned for the second quarter of 2021.

CORONA PANDEMIC DELAYING CONSTRUCTION PROGRESS

April 2020 | The Covid-19 crisis has brought about a two and a half week standstill on construction sites. However, the measures prescribed by the government, such as disinfecting the work equipment or maintaining safety distance, were quickly implemented, meaning that normal operation could be restored to some extent.

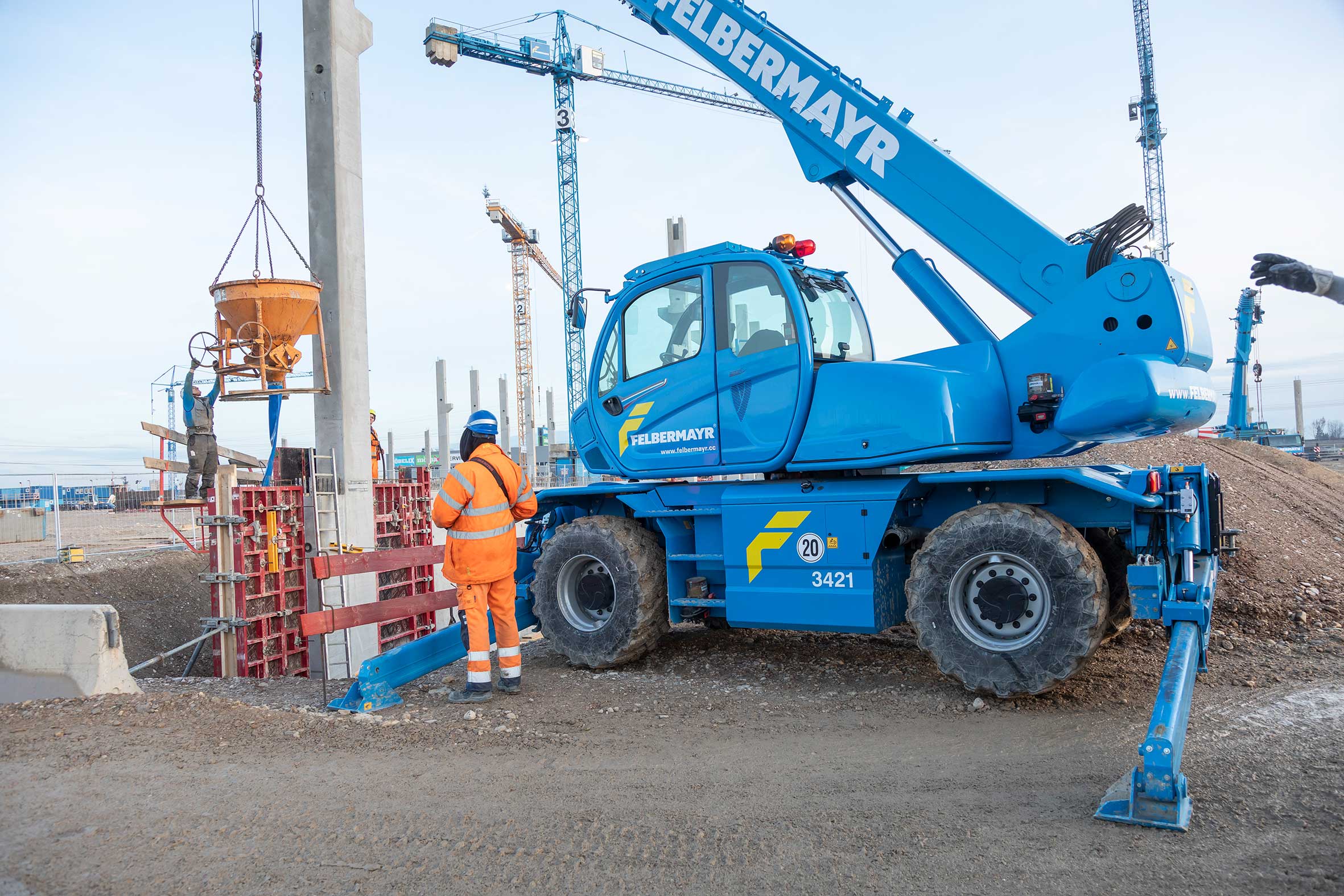

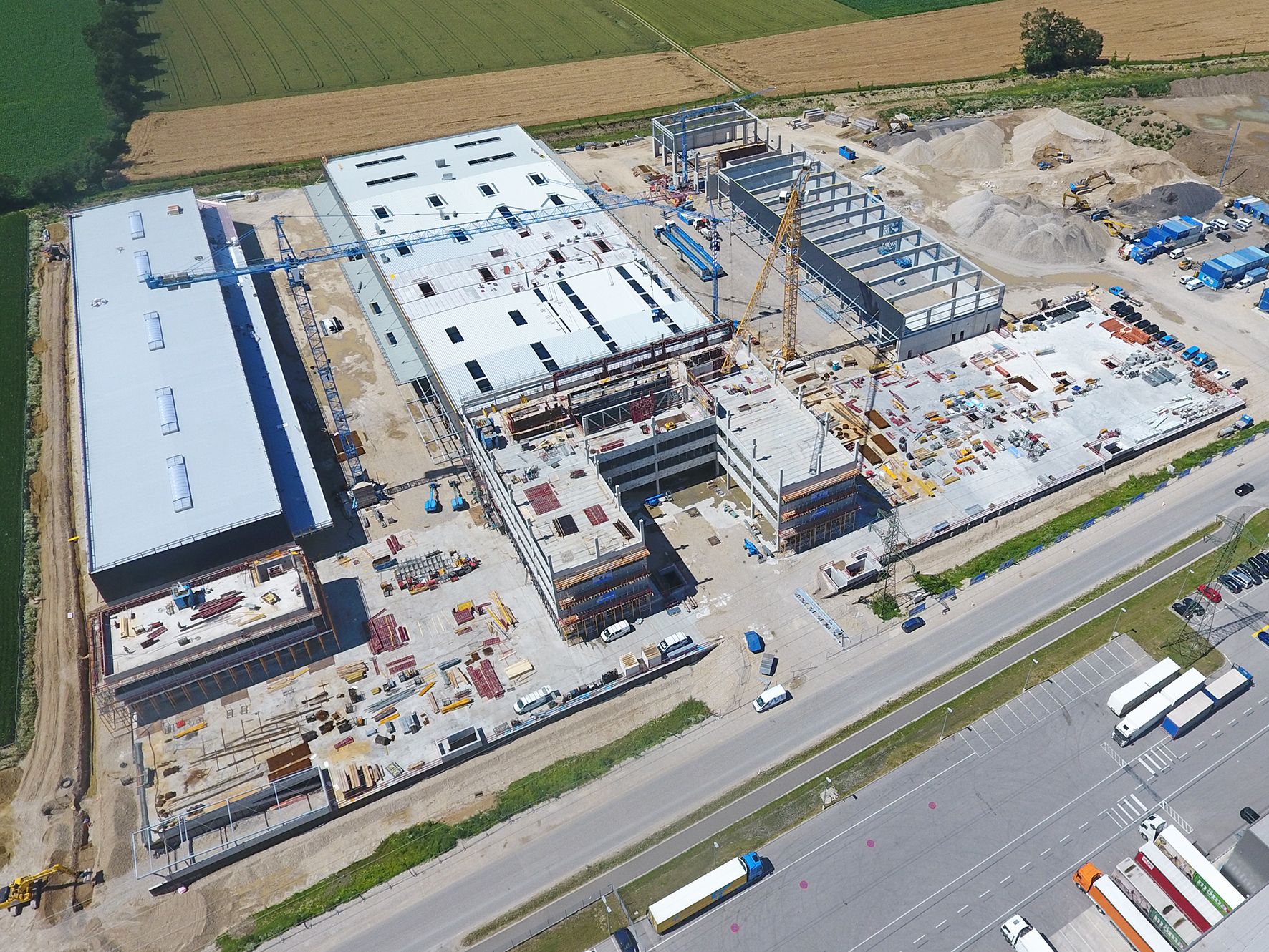

Before the shutdown, two thirds of the ceiling work of the underground car park, the construction of the ground floor of the office building and in hall 2 the ground floor and the first floor were able to be built. Currently, the locksmith work is being carried out in Hall 1, upon which the earthworks, i.e. the substructure for the monoplates, will be constructed. The foundation work for construction of the petrol station will soon be complete. Furthermore, the prefabricated elements (columns and beams) for Hall 2 are currently being put in place. Following this, the roofing work for this hall can commence.

FORMWORK AND CONCRETING WORK

February 2020 | After the turn of the year, the formwork and concreting work for the ceilings in the underground car park and in the basement of the workshop building began. So far, about 150,000 cubic metres of earth have been moved, 700 tonnes of reinforcing steel have been used and 8,200 cubic metres of concrete have been processed.

Surfacing works

December 2019 | Asphalting works is carried out throughout the whole underground car park by our road construction department. The reinforced concrete columns and walls have already been completed throughout the whole underground car park and the basement level of the future workshop building.


Channel works and roadworks

November 2019 | We continue with the construction of reinforced concrete columns and walls in the basement and the underground car park, which will be finished later. Channel works for the fresh water for the HGV washing facility and well drilling are being carried out. The substructure work in the underground car park and subsequent asphalting of the traffic routes will then follow.

Earthworks completed

October 2019 | After the earthworks were completed, soil stabilisation was carried out by means of sub-base course binders under the halls, along with clean-up and foundation work (strip foundations under the walls and point foundations under the columns) in the underground car park and workshop hall. The Felbermayr specialised civil engineering department secured the high-voltage masts using shotcreting. The channels in the underground car park area are being created.

Grounding-breaking and the start of construction

September 2019 | On the 17th September, Felbermayr celebrated the official grounding-breaking. A very personal and dignified ground-breaking was celebrated together with the Felbermayr family, the managing directors, the architects, as well as representatives from politics and business as well as the press.

Once the container village for the construction site workers, foremen and construction site management was constructed along with the construction roadways, the earthworks will start. For the construction, soil will be removed and a construction pit excavated for the underground car park. Foundation work is being carried out for the set-up of the construction cranes.
